Search

Home Battery Installation: Survey, Fitting and Handover

How long does fitting a home battery take? Does it matter if I already have solar panels? Who is allowed to do the wiring?

A step by step walk through the whole job, what changes the time and the price, how to pick and check an installer, the paperwork you should get at the end, and how the rules differ across the UK.

Sources last checked 7 October 2026

On this page
  1. Installation Step by Step
  2. Time and Cost Factors
  3. Who Can Do the Wiring
  4. Choosing an Installer
  5. DNO and Building Control
  6. At Handover
  7. Rules by UK Nation
  8. Energy Independence

A home battery installation is not a single day of work but a short sequence: a survey to check your supply and agree where the battery goes, a fitting visit for the mounting and wiring, commissioning to test and configure the system, and a handover where you receive the certificates and settings. In one Energy Saving Trust case study, a combined solar panel and battery installation took around four days on site1. The electrical work is regulated: in England and Wales it falls under Part P of the Building Regulations, and most of it must either be notified to building control or carried out by an electrician registered with a government-approved competent person scheme2.

Anyone with a home can potentially install a battery system, and the survey is where an installer establishes whether one suits the household and which type of system fits the house3. Batteries are typically sited in garages, on external walls or in utility rooms, depending on the system chosen4. Before the fitting day there are notifications to sort out: the local Distribution Network Operator is notified, and the local council may also need to be informed5. This page walks through the whole sequence, who may do the wiring, and what is handed over at the end.

The installation, step by step

The process begins well before anyone drills a wall. The first stage is the survey, and its purpose is wider than picking a spot for the unit. Installers can help identify whether a home battery is suitable for your needs and the best type of system for your house3. Where the installer makes a pre-application to a network or scheme for domestic low-carbon technology, the information collected includes the installation details and a photo of the cut-out, the point where your home's electricity supply enters9. That photograph exists because the supply arrangement determines what can be connected safely.

The fitting itself then follows a recognisable order:

  1. Survey and design. The installer checks the supply, agrees the battery location and sizes the system.
  2. Notifications. The Distribution Network Operator is notified, and the council may need to be informed5.
  3. Mounting and cabling. The battery is fixed in place, in a garage, on an external wall or in a utility room4, and the electrical connections are made.
  4. Commissioning. The system is tested and configured. Battery systems connected to on-site generation should be commissioned to MCS MIS 3012, the battery installation standard10.
  5. Handover. You receive the certificates, the warranty documents and an explanation of the settings.
A Sunsynk home battery storage unit mounted on the wall of a garage next to a parked electric car
A Sunsynk home battery storage unit mounted on the wall of a garage next to a parked electric car. Image: sunsynk.com

The on-site work is usually measured in days rather than weeks. In the Energy Saving Trust case study mentioned above, the solar panel and battery installation took around four days, and the household then used power from their home battery during the daytime, topped up by the solar panels1. A larger project can take longer: a park home insulation and heating installation took just over two weeks to complete11. A battery fitted on its own, without new panels, is generally the shorter job of the three, since the panel mounting and roof work are what consume most of the time in a combined installation.

What affects how long it takes and what it costs

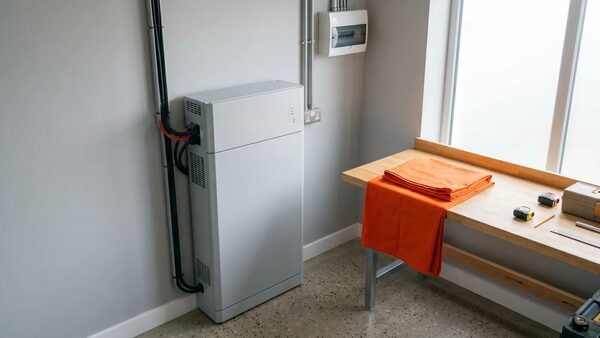

A white home battery storage unit installed on a wall next to a consumer unit, with a workbench and orange cloth nearby
A home battery beside the consumer unit Image: Fuse Energy

Two things above all shape how long the work takes and what it costs: whether the battery is going in alongside solar panels or on its own, and the capacity of the battery itself. The four-day case study was a combined solar and battery job1; a battery-only fitting avoids the roof work entirely. The two-week park home project involved insulation and heating measures as well, which is why it ran longer11.

On cost, the official MCS statistics for domestic retrofit battery installations give a sense of the market's shape. In the 2025-26 data, the smallest capacity band, 1 to 5.99 kWh, recorded 16,270 installations7. The capacity bands were chosen to cover distinct groupings: batteries approximately smaller than 6 kWh, approximately larger than 11 kWh, and a grouping in between7. Two cautions apply when reading any figures from that dataset. First, costs and capacities have been rounded to the nearest 107. Second, the recorded cost does not include the cost of any additional device installed with the battery, such as solar panels, nor any extended warranty or other material or works on the battery equipment7. A quote for a battery-plus-panels installation is therefore a different animal from the battery-only figures.

The siting choice also feeds the timescale. A battery in a garage on an external wall is usually a simpler cable run than one in a utility room at the far end of the house4. For a fuller picture of what drives the price, see home battery cost, and for how the capacity decision is made, what size home battery you need.

Who is qualified to do the electrical work

The wiring side of a battery installation is regulated work. Part P of the Building Regulations applies in England and Wales, and it covers electrical installations that operate at voltages not exceeding 1000 V a.c. in or attached to a dwelling2. The term dwelling includes houses, maisonettes and flats2. All new electrical work in a dwelling must be designed and installed to account for Part P12.

The rules distinguish between notifiable and non-notifiable work. Notifiable work includes new installations, house re-wires and the installation of new circuits, and it also includes additions to existing circuits in special locations, such as a room containing a bathtub or shower2. Additions and alterations to existing installations outside special locations, along with maintenance, replacement and repair work, are considered non-notifiable2. A home battery almost always involves at least one new circuit, which places it on the notifiable side.

Crucially, Part P applies to all electrical work in dwellings, whether carried out by professionals or DIYers2. In general, notification to a building control body, or full plans deposition, is needed only if the work is major, involves one or more complete new circuits, and is not carried out by an electrical contractor registered with an authorised competent person self-certification or third-party scheme2. A registered electrician is deemed competent to self-certify their work as compliant with the Building Regulations13. The stakes are real: failure to comply is a criminal offence, and local authorities have the power to require the removal or alteration of non-compliant work2.

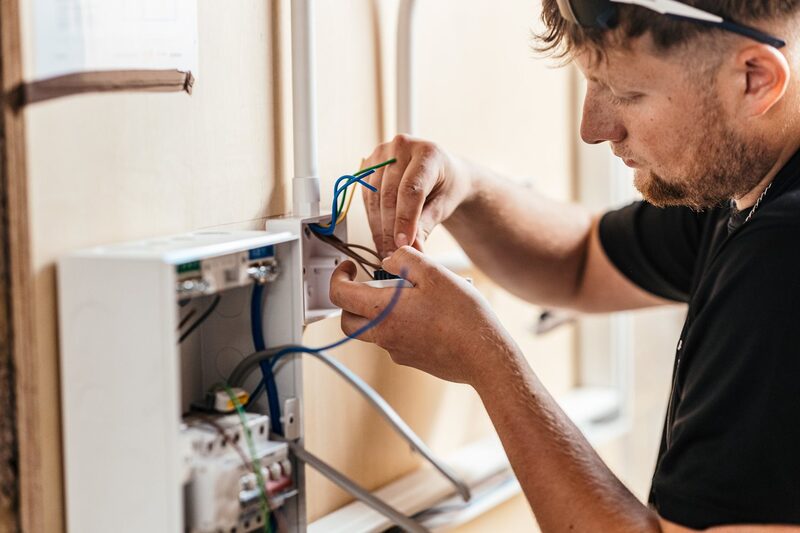

An electrician wiring a domestic consumer unit and electrical connections on a wall
An electrician wiring a domestic consumer unit and electrical connections on a wall. Image: NICEIC

Picking and vetting an installer

The first check is the scheme membership. Which? advises that you check your installer is signed up to the Renewable Energy Consumer Code (RECC), which now covers storage, and certified by the Microgeneration Certification Scheme (MCS), or alternatively certified by Flexi-Orb5. Solar Energy UK makes the same point from the other direction: MCS installers can help identify whether a home battery is suitable for your needs and the best type of system for your house3.

For the electrical work itself, two certification bodies dominate. NICEIC has been the UK's largest certification body for electrical businesses for almost 70 years, with over 40,000 currently certified6. It assesses, certifies and trains electricians, plumbers, renewable energy installers, and gas and heating engineers, and it certifies businesses rather than individuals, unless they are sole traders6. NICEIC-registered electricians are assessed on an annual basis13. NAPIT is a certification body and training provider with over 20,000 members in the electrical industry15, and installers accredited by NAPIT can submit a building regulations application on your behalf16.

If you want an installer who is MCS-certified specifically for storage, NICEIC offers MCS certification for four key technologies: solar heating, solar photovoltaic systems, heat pumps, and electrical energy storage systems (EESS), and it is accredited by UKAS to offer the redeveloped scheme17. From 9 March 2026, all new applicants were automatically assessed under the redeveloped scheme17.

If something goes wrong, both bodies have complaints routes. NAPIT's policy is to review all complaints with impartiality, with any communication responded to within 10 working days18. The process applies when a NAPIT-certificated company has been contracted or subcontracted to carry out work covered by the scope of their certification, and a complaint may be made by any person who has had work completed by a member certified for the relevant scope of work at the time18. NAPIT can investigate complaints against registered businesses and tradespeople where a lack of technical competence is a concern19. Two limits matter: the responsibility for any required remediation lies with the member, and NAPIT will not compensate or reimburse monies in regard to non-compliant work19.

Telling the DNO, building control and the council

There are three separate notifications to think about, and they go to three different places.

  • The Distribution Network Operator (DNO). Where a storage system is being installed, the local DNO is notified5. This is about the network knowing what is connected to it, and it is separate from planning and building control. The detail is covered in telling the network operator about a home battery.
  • Building control. In England and Wales, notifiable electrical work must either be notified to local authority building control or self-certified by a registered competent person2. An installer accredited by NAPIT can submit the building regulations application on the householder's behalf16.
  • The council. The local council may also need to be informed5. The Planning Portal's guidance on sustainable home energy solutions makes the general point that understanding the planning and building regulations is crucial for safe, efficient installations and accessing incentives20.

The installation standards sit alongside the notifications. Current scheme rules define domestic batteries as electrochemical batteries installed to be used in conjunction with solar PV panels in residential buildings, and require them to be installed in compliance with the latest version of the quality and installation standards, including the MCS battery installation standard, PAS 63100 and PAS 20358. The Welsh approved document consultation states that on-site electricity storage and battery systems connected to on-site electricity generation should be commissioned to the MCS battery installation standard10. This standards framework is relatively recent: an official fire safety literature review from 2017 recorded that there were then no UK installation standards for these systems21. The full standards picture is set out in the standards governing home battery installation.

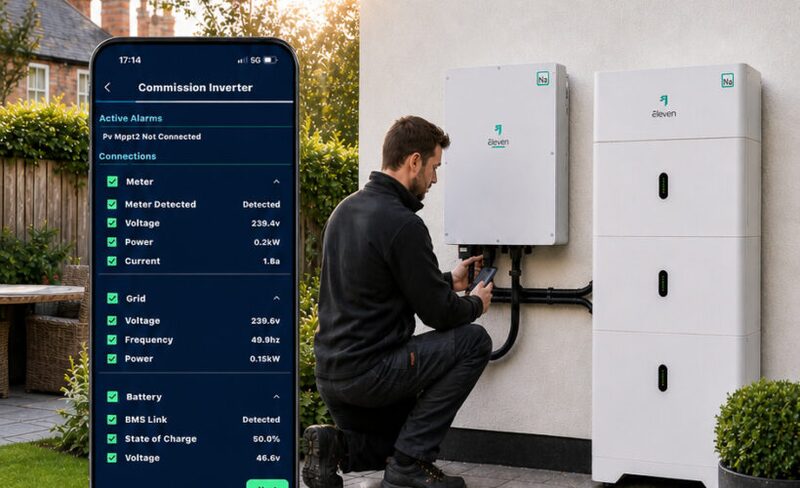

A technician kneeling outside a house commissioning an Eleven sodium-ion battery and inverter installation, with a phone app screen overlaid showing inverter commissioning details
A technician kneeling outside a house commissioning an Eleven sodium-ion battery and inverter installation, with a phone app screen overlaid showing inverter commissioning details. Image: Eleven Energy

What to expect at handover

Handover is the stage that is easiest to shortchange, because by then the hard work is done and everyone wants the house back. It is also the stage that determines whether you can prove the installation was done properly, years later.

At a minimum, the handover should leave you with:

  • Proof of Part P compliance. Either the installer's self-certification under a competent person scheme or the building control approval2. This matters beyond the day itself: Electrical Safety First notes that electrical work complying with Part P will be reported in the Home Information Pack as part of local authority searches14.
  • The commissioning record. Commissioning to MIS 3012 is the standard for battery systems connected to on-site generation10, and the commissioning sheet is your evidence it happened.
  • The warranty documents. The MCS cost data explicitly excludes extended warranties from the recorded installation cost7, so any warranty you bought is a separate document to keep. The terms are covered in home battery warranties.
  • The settings and access details. The monitoring app, the account and the charge and discharge settings as configured at commissioning. Monitoring is covered in monitoring a home battery.

One question belongs at handover even though it is really a design decision: whether the battery will work in a power cut. Not all systems are suitable for power cuts, so ask your installer whether your battery will work in an outage, and for how long5. If backup matters to you, the detail is in battery backup in a power cut.

How the rules vary across England, Scotland, Wales and Northern Ireland

The sharpest difference is in the building regulations framework. Part P of the Building Regulations applies in England and Wales13, covering electrical installations in or attached to dwellings at voltages not exceeding 1000 V a.c.2. Richmond Council's guidance for householders, an English authority, states that all new electrical work in a dwelling must be designed and installed to account for the new Part P12. Scotland and Northern Ireland have their own building standards systems, and the Part P competent person route described on this page does not apply there; the certification bodies themselves, NICEIC and NAPIT, operate UK-wide, so an installer's registration can still be checked in all four nations6.

Within England and Wales there are differences in the detail of what the approved documents expect. The Welsh consultation version of Approved Document L addresses on-site electricity storage and battery systems directly, stating that systems connected to on-site generation should be commissioned to MCS MIS 301210. Wales is also moving faster on the wider policy: an amendment to Part L of the Building Regulations in Wales makes solar a functional requirement for new homes and non-domestic buildings where construction has not started, from 4 March 2027.

The notification to the Distribution Network Operator applies across Great Britain, since the distribution networks cover England, Scotland and Wales5. The MCS installation standards, MIS 3012, PAS 63100 and PAS 2035, are UK-wide scheme requirements rather than nation-specific law8. Planning permission for the battery itself is a separate question in each nation, covered in the pages on planning permission in England, Scotland, Wales and Northern Ireland.

The installation and your energy independence

The purpose of the whole exercise is captured by Energy Saving Trust: combining solar panels with a home battery lets you store free, renewable electricity to power your heat pump, which makes you less reliant on grid electricity22. In the four-day case study, the household used power from their home battery during the daytime, topped up by the solar panels1. Batteries are, at their core, a way for homeowners to store excess electricity produced from their solar system3.

The independence gained is real but bounded, and the installation process itself shows where the boundaries sit. A fitted battery reduces day-to-day reliance on a supplier's daytime electricity, but the household remains connected to the network, must notify the Distribution Network Operator, and depends on that connection for import and export5. Backup capability is not automatic: not all systems work in a power cut, and the answer has to come from your installer before the fitting day5. And the system's long-term performance depends on the manufacturer's warranty terms and the monitoring platform, both of which are handed over at the end of the job rather than solved by it7.

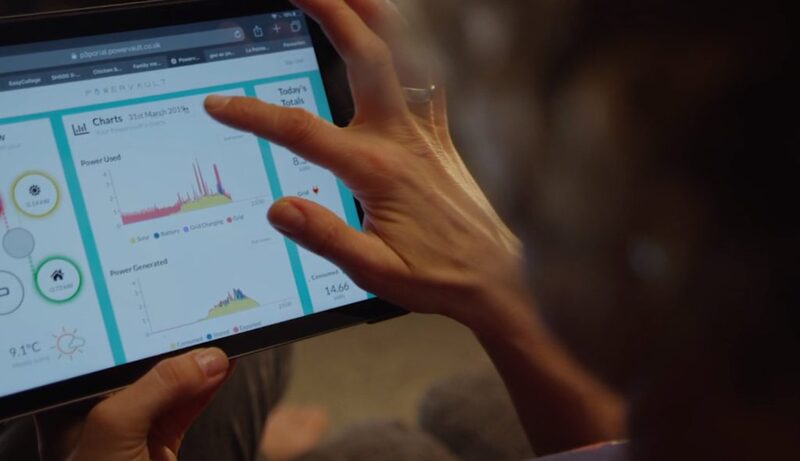

A person holding a tablet displaying the Powervault energy monitoring dashboard with charts of power used and generated
A person holding a tablet displaying the Powervault energy monitoring dashboard with charts of power used and generated. Image: Powervault

What a properly installed battery does deliver is a home that runs more of its own day on its own stored power, with paperwork that proves the work was done to the standards that now exist, where none did in 201721. The wider picture of what that adds up to is in home batteries and household energy independence, and the overview of the whole subject starts at home battery storage.

Sources22 sources
  1. Beth Martin's story: solar panels and an electric vehicle, Energy Saving Trust, 2025-03-03
  2. Part P of the Building Regulations: frequently asked questions, IET, 2026-09-17
  3. Batteries in the home, Solar Energy UK, 2026-09-17
  4. Battery storage advice, Energy Saving Trust, 2026-08-19
  5. Solar panel battery storage, Which?, 2026-05-14
  6. NICEIC householders and landlords help hub, NICEIC, 2026-09-17
  7. MCS domestic retrofit battery installations 2025-26, MCS, 2026-05-28
  8. Warm Homes: Social Housing Fund wave 3 scheme guidance, May 2026 addendum, Department for Energy Security and Net Zero, 2026-06
  9. Connect Direct, Energy Networks Association, 2026-09-17
  10. Approved Document L volume 1 consultation version, Welsh Government, 2025-08
  11. Insulation solutions Scotland, Energy Saving Trust, 2026-09-17
  12. Building regulations and electrical works, London Borough of Richmond upon Thames, 2026-06-02
  13. Wiring a shed: a guide for homeowners, NICEIC, 2026-09-17
  14. House buyer beware: illegal electrics in hundreds of homes, Electrical Safety First, 2026-09-19
  15. NAPIT urges Government to rethink pay-per-mile scheme for electric vehicles, NAPIT, 2026-02-24
  16. Building regulations: renewables guidance, Bedford Borough Council, 2026-09-17
  17. Redeveloped MCS installer scheme: key changes and benefits, NICEIC, 2026-03-09
  18. NAPIT complaints against members policy, NAPIT, 2026-09-20
  19. NAPIT FAQs, NAPIT, 2026-09-17
  20. Sustainable home energy solutions, Planning Portal, 2024-09-02
  21. Fire and solar PV systems: literature review, Department for Energy Security and Net Zero, 2017-07-17
  22. How to ensure a heat pump runs efficiently, Energy Saving Trust, 2026-05-19

Questions

Some answers here, the rest on their own pages.

How long does a home battery installation take?

A solar panel and battery installation together took around four days in one Energy Saving Trust case study, while a larger park home insulation and heating project took just over two weeks. A battery on its own is usually shorter than either, because the panels are the more labour-intensive part. The survey and any network operator notification happen before the fitting day, so the total time from first enquiry to a working battery is longer than the on-site work alone.

Who is legally allowed to install a home battery?

The electrical work falls under Part P of the Building Regulations in England and Wales, which applies whether the work is done by a professional or by someone carrying out DIY. Most notifiable work must either be reported to local authority building control or carried out by an electrician registered as a competent person with a government-approved scheme. Failure to comply is a criminal offence, and local authorities can require non-compliant work to be removed or altered.

Do I need to tell my electricity network operator about a battery?

Yes. If you are installing a storage system you should notify your local Distribution Network Operator, and you may also need to inform your local council. This is separate from any building regulations notification. Your installer normally handles the network notification, and the details of the connection, including the supply arrangement at your cut-out, are part of what is collected at the survey stage.

What certificates should I receive after the installation?

You should receive confirmation that the electrical work complies with Part P of the Building Regulations, either through your installer's self-certification under a competent person scheme or through a building control approval. If the installation is MCS-certified you should also receive the scheme documentation. Ask your installer whether the battery will work in a power outage and for how long, and keep every document, because compliant electrical work is reported in local authority searches.

Will my battery work in a power cut?

Not automatically. Not all systems are suitable for power cuts, so this is a question to ask your installer before the fitting day, along with how long the battery would keep essential things running. Backup capability depends on the inverter and how the system is wired, not on the battery alone, and it is one of the settings that should be confirmed at commissioning and explained at handover.

What standards should the installation meet?

Current scheme rules require domestic batteries to be installed in compliance with the latest quality and installation standards, including MCS MIS 3012, PAS 63100 and PAS 2035. Battery systems connected to on-site generation should be commissioned to MCS MIS 3012, the battery installation standard. An older official review noted there were then no UK installation standards specific to these systems, which is why the current standards list matters when checking an installer.

Can I complain if the installation is faulty?

Yes, through your installer first, and then through their certification body. NAPIT, for example, asks that you formally contact the member and allow a minimum of 14 days for acknowledgement before submitting its complaints form. NAPIT reviews complaints with impartiality and can investigate concerns about technical competence, but it does not pay compensation or fund third-party rectification: remediation is the member's responsibility.
