On this page
A home charge point is not a plug on a lead. It is a new electrical circuit, run on its own from your consumer unit, protected by its own devices and designed to carry a heavy current for hours at a stretch. That is the heart of the electrical requirements: each EV charging point must be supplied by its own dedicated final circuit, designed as a continuously-rated load, and installed to BS 7671, the UK's national standard for electrical installations1. Because the work creates a new circuit, it is notifiable under the Building Regulations in England and Wales, and it must be certified when it is finished2.
The practical questions most households arrive with are simple. Can the house's supply take the extra load, or does the fuse need upgrading? Can the car just be plugged into a normal socket instead? Who is allowed to do the work, and what paperwork should land on the doormat afterwards? This page answers each of those, and sets out where the rules come from: BS 7671 Section 722 for the installation itself, Part P for the notification regime, Part S for new builds, and the grant schemes' own standards for anyone claiming public money.
Supply requirements for domestic EV charging points
The starting point is the circuit. Section 722 of BS 7671, which sets the requirements for electric vehicle charging installations, requires that each EV charging point is supplied by its own dedicated final circuit1. In practice that means a cable run from the consumer unit to the charge point position, protected by its own breaker, serving nothing else in the house. The circuit must be designed as a continuously-rated load, because a charge can run for six to 12 hours without a break, and a circuit sized for intermittent use is not adequate for that duty1.
Protection comes in layers. Where the charger has built-in DC fault current detection to 6mA, a Type A RCD rated at 30mA is sufficient1. Earthing is the other critical piece: most local authorities specify that households install a dedicated EV charger with protective earth neutral (PEN) fault protection, because a fault on a TN-C-S supply can otherwise put a dangerous voltage on the charger's earthed metalwork6. The installer's job, under the IET Code of Practice, includes assessing the adequacy of supply capacity for the new EV load plus the existing load, and assessing the adequacy of the earthing arrangement before anything is fixed to the wall7.
The checks an installer must make before the work starts, under the IET Code of Practice, include:
- Assessing the adequacy of supply capacity for the new EV load plus the existing load7
- Assessing the adequacy of the earthing arrangement7
- Confirming the circuit is designed as a continuously-rated load1
- Verifying RCD protection suited to the charger's own fault detection1
Since 2021 there is also a smartness requirement sitting alongside the electrical one. The Electric Vehicles (Smart Charge Points) Regulations 2021 require that domestic EV chargers are smart, capable of responding to signals to shift charging to off-peak periods1. That does not change the wiring, but it does mean the unit installed must meet functional requirements as well as electrical ones, a subject covered in full on our page about smart charge point regulations.

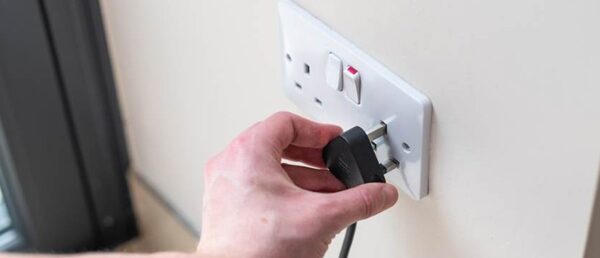

Why plugging into a 13A socket is not enough

Slow charging at home can be carried out using a standard 3-pin socket, but because of the higher current demands of EV charging, a dedicated unit is strongly recommended for regular charging8. The reason is duty, not just speed. A domestic socket is designed for appliances that draw heavily for minutes or an hour; an EV on a 3-pin lead can draw close to the socket's maximum for an entire night, every night, and the socket's own standard recognises the difference: BS 1363-2 requires EV marked socket-outlets used for charging electric vehicles to be subjected to additional testing requirements9.
The performance gap is real too. Chargers in the 3kW to 7kW band generally take six to 12 hours to recharge a car from 20 to 80 per cent or above10, and a dedicated charge point is recommended over a standard household socket to achieve faster charging speeds11. For anyone charging regularly at home, the recommendation from independent guides is unambiguous: get a dedicated EV charging point installed by an accredited installer8.
BS 7671 Section 722: the wiring rules that apply
Every EV charging installation must comply with BS 7671, the IET Wiring Regulations, the UK's national standard for the design, erection and verification of electrical installations12. The current edition is BS 7671:2018+A4:2026, published on 15 April 2026, which supersedes BS 7671:2018+A2:2022+A3:202414. Within that standard, Section 722 is the part that matters here: it sets the requirements for electric vehicle charging installations, adding specific rules on top of the general ones that apply to any circuit1.
The installer's competence is measured against this framework. To install EV chargers, an installer needs competence in the IET Code of Practice for Electric Vehicle Charging as well as the Wiring Regulations themselves1. For the householder, the practical significance is that a charge point is not a like-for-like swap for a socket or a light fitting: the additional requirements of Section 722, covering things like the circuit arrangement, protection and external influences at the charging position, are part of what is being paid for when a qualified installer does the work. Our page on EV charge point safety, standards and certification covers how the equipment itself is tested.
Notifiable work under Part P and who may certify it

Part P of the Building Regulations applies to electrical installations operating at voltages not exceeding 1000 V a.c., in or attached to a dwelling, and the term dwelling includes houses, maisonettes and flats15. It applies to all electrical work in dwellings, whether carried out by professionals or DIYers15. Notifiable work includes new installations, house re-wires and the installation of new circuits, as well as additions or alterations to existing circuits in special locations such as a room containing a bathtub or shower15. In Wales, the notifiable works are explained in Approved Document P Section 0 and include new circuits back to the consumer unit and additions or alterations to existing circuits in kitchens, bathrooms and outdoors16.
A charge point sits squarely inside that definition. The work itself is deemed notifiable work because it involves creating a new circuit2. Building regulations approval is always required when installing an EV home charger, and it may be achieved through a competent person or the local building control body17. With the exception of some minor tasks, electrical work must either be reported to the local authority building control body or carried out by a registered electrician who is a member of a Government-approved scheme18.
The two routes to approval work like this:
| Route | Who notifies | When |
|---|---|---|
| Registered installer (Competent Person Scheme) | The installer self-certifies and notifies building control on the householder's behalf13 | As part of the job |
| Unregistered installer or DIY | The work must be reported to the local authority's Building Control13 | 48 hours before the work starts |
The building control body or registered third-party certifier must be notified before work starts19.
Part P applies in England and Wales only
The territorial line matters. Electricians working in England and Wales must comply with Part P18. Scotland has its own building regulations system, so the Part P notification regime does not apply there, although the electrical installation itself must still meet BS 7671 wherever in the UK it is carried out12.
Scotland has, however, adopted its own charge point requirements for buildings. The Building (Scotland) Regulations include provisions comparable to England's Part S, in force from 5 June 2023, and the Scottish Government's policy proposals set out EV charge point requirements for new and renovated buildings21. Under those proposals, if a car park has fewer than 4 accessible parking spaces, at least one of those spaces should have access to an EV charge point socket21. Grant rules also reflect the devolved picture: the EV chargepoint grant for residential landlords operates across England, Wales, Scotland and Northern Ireland, but excludes buildings where chargepoint installation was already a mandatory requirement, whether under Part S in England from 15 June 2022 or the Building (Scotland) Regulations from 5 June 202322.

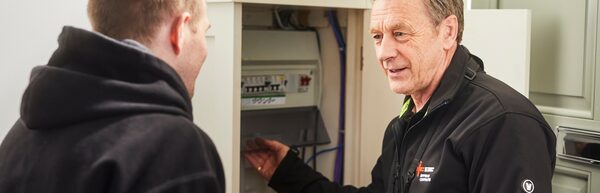

Load checks, service fuses and the supply capacity question

Before a charger goes in, someone has to answer a question the householder cannot: can this supply take the load? The IET Code of Practice makes it the installer's responsibility to assess the adequacy of supply capacity for the new EV load plus the existing load7. The answer determines the route the installation takes with the network operator.

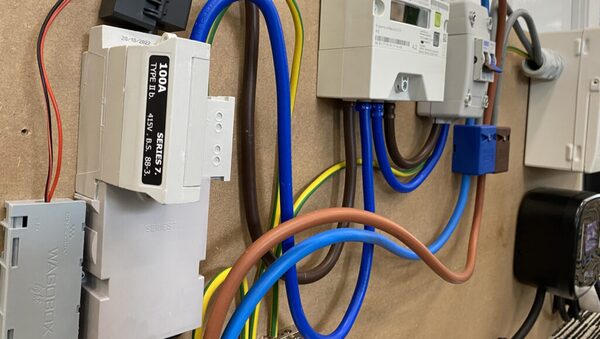

The dividing line is 60 amps. If the total demand of the property is 60 amps or less and there are no safety concerns, the installer does not need to apply in advance: the charge point can be installed and the network operator notified retrospectively, within 28 days3. Where the proposed addition is assessed by the installer to be within the existing rating of the supply equipment and the maximum demand is 60A or less, that retrospective notification route is available; the Energy Networks Association's guidance also requires that the network operator is informed every time a charge point is installed at an existing property7. Where the maximum demand of the whole customer connection is less than 13.8 kVA, the ENA must be notified by email within one month of installation9.
If the total demand is more than 60 amps, or the installation does not qualify against the other criteria, a formal load check is required: the installer must apply and wait for permission before installing the EV charger3. If the assessment shows the supply requires an upgrade, that upgrade must be completed before the charger is installed3. Some network operators ask to be contacted before installation regardless: in the Electricity North West area, the installer should contact the network before a charge point is installed23.
The two routes side by side:
| Simplified route | Formal application | |
|---|---|---|
| Applies when | Total property demand is 60 amps or less, no safety concerns3 | Demand above 60 amps, or other criteria not met3 |
| Timing | Install first, notify the network operator within 28 days3 | Apply and wait for permission before installing3 |
| Supply upgrade | Not expected, as the addition is within the existing rating7 | Must be completed before the charger is installed3 |
Our page on telling the network operator about a home EV charger covers the process in detail, and load management explains how a charger that modulates its own output can keep a property within its existing supply capacity.
A 7kW socket for every parking space in new homes
For new homes the requirements are set in advance, not negotiated per installation. The Scottish Government's policy proposals require all dwellings with a parking space to have at least one EV charge point socket with a minimum 7kW output power rating4. For residential buildings undergoing major renovation with more than 10 car parking spaces, charge point sockets with the same minimum 7kW rating must be installed in as many residential car parking spaces as the post-renovation electrical capacity allows, with ducting installed in each residential car parking space, and the cost of recharging and ducting infrastructure capped at 7% of the total major renovation cost4.
In England, the equivalent rules sit in Part S of the Building Regulations, and Approved Document S provides the technical guidance on the installation and charge point requirements for electric vehicles24. The underlying legislation requires that, for residential buildings undergoing major renovation with more than 10 spaces, at least one associated parking space for the use of each dwelling must have access to an electric vehicle charge point, and the same access requirement applies to dwellings resulting from a material change of use25. Non-residential buildings have their own ratios: for buildings with more than 10 non-residential parking spaces, the policy proposals set ducting requirements and charge point socket provision, and for existing buildings with more than 20 non-residential parking spaces there was a compliance deadline of 1 January 20254. The full picture across the four nations is on our page about EV charge point requirements for new build homes.
Installation requirements set by grant schemes

Public money comes with strings attached, and the strings are about standards. The Electric Vehicle Chargepoint Grant for Households with On-Street Parking requires an OZEV approved installer to complete the installation of the chargepoint26. The chargepoint grant for residential landlords likewise requires an OZEV-authorised installer and an eligible residential chargepoint, and the property must be located in England, Wales, Scotland or Northern Ireland22. For the closed Homecharge scheme era, the same principle applied: the wall charging unit had to be installed by a supplier approved by the Office for Zero Emission Vehicles, who claimed the grant on the householder's behalf27.
The installation standards behind those grants are explicit. Chargepoint installations must be carried out as per BS EN 61851, the IET Wiring Regulations BS 7671, the IET Code of Practice for Electric Vehicle Charging Equipment Installations, and the Electricity Safety, Quality and Continuity Regulations28. Chargepoints must be installed on a residential property, and must meet the needs of EV owners with disabilities or mobility issues28. Independent certification bodies also test EV chargers against electrical safety criteria and offer certification covering legislative, market access, specifier and compliance requirements, which is how a charge point demonstrates it meets the standards the grant schemes reference29.
In summary, a grant-funded installation must satisfy:
- An OZEV-approved or OZEV-authorised installer26
- Installation to BS EN 61851, BS 7671, the IET Code of Practice and the Electricity Safety, Quality and Continuity Regulations28
- A residential property, with the chargepoint meeting the needs of EV owners with disabilities or mobility issues28
Proving competence and certifying the finished job
When the installation is finished, paperwork follows, and it is worth knowing what should arrive. An EIC, an Electrical Installation Certificate, must be issued for the charger installation1. A Building Regulation Certificate of Compliance is required for any notifiable electrical job, and the examples of notifiable work read like a charge point installation: changes to a consumer unit, the installation of new circuits, any addition or alteration to an existing circuit in a special location30. The compliance certificate proves the work complies with building regulations2.
Competence is the other half of the picture. The recommendation is to use a reputable company and ensure the installer has the relevant qualifications2; independent guidance says to hire an electrician registered with a recognised certification body, like NICEIC13, and to look for installers holding certifications from government-approved registering bodies as a guarantee of their competence11. If a charger breaks, the advice is not to attempt a repair: that is a job for a professional electrician with the qualifications and certifications13. The full process, from survey to sign-off, is on our page about home EV charge point installation.
The household freedom that compliance delivers

A compliant charge point is one of the few additions to a house that increases independence rather than dependence. Charging at home on a dedicated circuit means the car's fuel comes through the house's own supply, at domestic rates, overnight, rather than from a public network where 49% of chargers are rated standard, 3kW to less than 8kW, and prices and availability are set by operators5. A 7kW home unit takes a car from 20 to 80 per cent in six to 12 hours10, comfortably inside an off-peak window on an EV tariff, and a smart charger can respond to signals to shift that charging automatically1.
The dependence that remains should be stated plainly. The installation is up to the householder to get right: installing a home charger is classified as development, so it is up to the householder to ensure the correct permissions are in place31. The supply itself still comes from the network, and a load check or supply upgrade may be needed before the charger can be fitted at all3. The charger's smart functions depend on its manufacturer's app and connectivity, covered on our page about EV charger apps and connectivity. And the certificates matter beyond the day of installation: they are the evidence, when the house is sold, that the electrical work was done legally and safely20. What compliance buys, in the end, is a charging installation the household can rely on, that the law recognises, and that the next owner will thank you for.
