On this page
In England, some domestic wind turbines can be installed without applying to the council for planning permission, under what are called permitted development rights. This applies only where every one of a set of limits and conditions is met: the turbine must be small enough, far enough from the boundary, certified to the right standard, and sited on land that carries no special protection1. Where any limit is broken, or the rights have been withdrawn in your area, a planning application is needed.
The two categories are treated differently. A stand-alone turbine, one mounted on its own pole or tower within the boundaries of a dwellinghouse, must not exceed 11.1 metres at its highest point, including blades3. A building-mounted turbine, on a detached house or a detached building within the curtilage, must not protrude more than three metres above the highest part of the roof, excluding the chimney, or exceed 15 metres in total height, whichever is the lesser4. The underlying rules come from Class H of Schedule 2, Part 14 of the Town and Country Planning (General Permitted Development) (England) Order 20155.
England's permitted development: cases where planning permission is unnecessary
Permitted development is a national grant of planning permission. Instead of applying to the council, a householder may carry out specified works provided the works stay within limits and conditions set out in the legislation. For domestic wind turbines in England, the Planning Portal states that "under permitted development rights in some cases it is possible to install domestic wind turbines without the need for an application for planning permission, so long as specified limits and conditions are met"2. The rights are conditional, not absolute: miss one condition and the whole route closes, leaving a formal application as the only lawful path.
The rights are split by type. The installation, alteration or replacement of a stand-alone wind turbine within the boundaries of a dwellinghouse can be permitted development provided all the listed limits and conditions are met3. Building-mounted turbines have their own set of rules, which apply only to detached houses and to detached buildings within the boundaries of a house or block of flats4. In all other cases, an application for planning permission from the local authority is needed to add a domestic wind turbine, whether on the house or in the surrounding grounds1.

Two cautions sit alongside the headline. First, this is an introductory guide rather than a definitive legal source: local rules may also apply, and the position of an individual property depends on designations and directions that only the council can confirm1. Second, permitted development deals with planning permission only. Building regulations are a separate consent, and for a turbine attached to the house they will normally apply, covering the structure and the electrical installation6. A turbine that is lawful under planning rules can still be unlawful if the building regulations side is ignored.
Free-standing turbines: the 11.1 metre height cap and siting rules

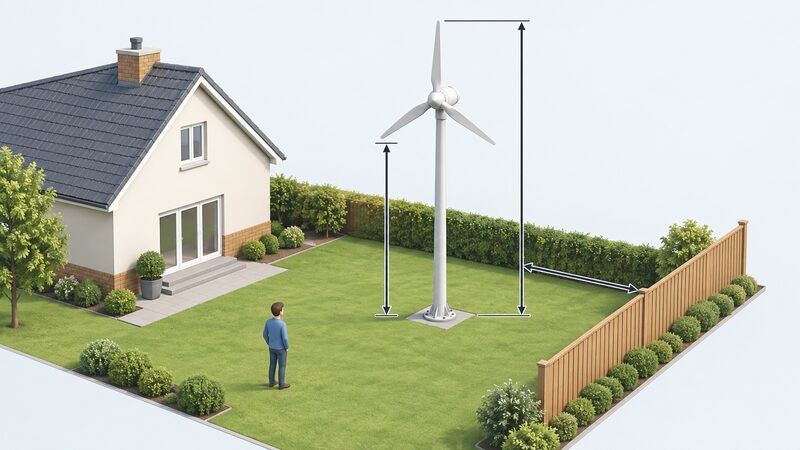

The stand-alone rules are the tighter of the two sets, and the height limit is the figure most households hit first. The highest part of a stand-alone wind turbine, including the blades, must not exceed 11.1 metres3. That is a hard ceiling, not a target: a turbine that rises above it is outside permitted development however well it is sited.
The second limit is a setback rule that scales with the turbine itself. An installation is not permitted if any part of the stand-alone turbine, including blades, would be closer to the boundary than a distance equivalent to the turbine's overall height plus 10 per cent of that height, measured from any point along the property boundary3. A smaller turbine needs proportionally less clearance, but the arithmetic must be done against the actual machine, mast included.
Three further size and siting conditions apply. The swept area of any blade must be no more than 3.8 square metres3. The distance between ground level and the lowest part of any blade must not be less than five metres3. And the installation must not be sited on safeguarded land3. These limits come from Class H of the 2015 Order, which states that development is not permitted where "the swept area of any blade of the wind turbine would exceed 3.8 square metres" or where any part would sit within 5 metres of a boundary of the curtilage in the building-mounted case5. For most suburban plots, the setback rule rather than the height limit is what rules a stand-alone turbine out: a garden that cannot accommodate a clearance circle of the required size cannot accommodate a full-height turbine under permitted development.
Turbines on buildings: how far above the roof and the five metre rule
Building-mounted turbines are governed by a different pair of numbers. No part of the turbine, including blades, may protrude more than three metres above the highest part of the roof, excluding the chimney, and the turbine must not exceed 15 metres in height overall, whichever of those two limits is the lesser4. On a typical two-storey house the three metre protrusion limit bites long before the 15 metre cap, so it is the operative figure in practice.
The boundary rule is fixed rather than scaled. No part of the building-mounted turbine, including blades, must be within five metres of any boundary4. This is a flat distance, unlike the stand-alone rule that grows with turbine height, and it applies to the blades at their full sweep, not just the mast or frame. The blade clearance rule also applies here: the distance between ground level and the lowest part of any blade must not be less than five metres4, which on a low single-storey roof can be the harder condition to satisfy.
The swept area limit matches the stand-alone rule at no more than 3.8 square metres per blade4. There is also a conservation area restriction: in Conservation Areas, an installation is not permitted if the building-mounted turbine is on a wall or roof slope which fronts a highway4. The eligibility rules matter as much as the dimensions. Permitted development rights for building-mounted turbines apply only to installations on detached houses, not blocks of flats, and on other detached buildings within the boundaries of a house or block of flats4. A block of flats must consist wholly of flats, with no commercial premises, for the curtilage provisions to be available4. On a semi-detached or terraced house, the building-mounted route is not open at all, and the same applies to the stand-alone rights in respect of the house itself: the rights attach to dwellinghouses and their curtilage, not to any building whatever.
Rules for both kinds: MCS certification, materials and taking them down

Beyond the size limits, both routes carry the same substantive conditions, and they are conditions on the equipment and the household's conduct, not just the geometry.
- MCS standards. The installation must comply with the Microgeneration Certification Scheme Planning Standards, MCS 020, or equivalent standards3. The legislation puts it plainly: "Development is not permitted by Class H unless the wind turbine complies with the MCS Planning Standards or equivalent standards"5. The scheme includes clear standards to support the installation of wind turbines and air source heat pumps.
- Non-reflective blades. The turbine must use non-reflective materials on blades3.
- Siting. The installation must be sited, so far as is practicable, to minimise its effect on the external appearance of the building and its effect on the amenity of the area3.
- Safeguarded land. The installation must not be sited on safeguarded land3.
- Removal. The turbine must be removed as soon as reasonably practicable when no longer needed for microgeneration3.
The MCS condition deserves emphasis because it links planning to product certification. A turbine that has not been certified to MCS 020 or an equivalent standard cannot use permitted development however small it is, which means the certification status of the specific machine is a planning question, not only a quality one. The removal condition is the other one households overlook: permitted development is a permission for a working microgeneration installation, and a turbine that has stopped generating and stays up loses its footing. Building regulations run alongside: for a turbine attached to the house, building regulations will normally apply, and they also cover the electrical installation and other aspects of the work6. An installer registered with the relevant competent person scheme, listed in Row 17 of Schedule 3 of the Building Regulations, may be authorised to self-certify the work without involving local authority building control6.
A single turbine, and no air source heat pump alongside it
The permitted development rights for wind turbines interact with those for air source heat pumps in a way that catches out households combining technologies. Only the first installation of any wind turbine at a property is permitted development, and only if there is no existing air source heat pump at the property. Additional wind turbines or air source heat pumps at the same property require an application for planning permission3.
The heat pump rules mirror this from the other side. Under Class G, development is not permitted if a wind turbine is installed on the same building or within the curtilage of the dwellinghouse or block of flats, and the same applies where a stand-alone wind turbine is installed within the curtilage7. The Planning Portal's air source heat pump guidance states the same position: development is permitted only if there is no existing wind turbine on a building or within the curtilage of that property8. Croydon Council's retrofit guidance confirms that installing an air source heat pump is permitted development, subject to its own conditions9.
The practical consequence is that a household cannot stack the two rights. A home with an air source heat pump installed under permitted development cannot add a wind turbine without a planning application, and a home with a permitted turbine cannot add a heat pump the same way. Ground source heat pumps sit outside this clash: they are typically considered permitted development without the same interaction9. For a household building energy independence in stages, the order of installation matters, because whichever technology goes in first under permitted development closes the permitted route for the other.
Situations outside permitted development

Certain locations are excluded from the wind turbine rights altogether, regardless of size or certification.
- Listed buildings. Permitted development rights do not apply to a turbine within the curtilage of a Listed Building3. For listed buildings, planning permission and listed building consent are required9.
- Scheduled Monuments. The rights do not apply within a site designated as a Scheduled Monument3.
- Designated land. The rights do not apply on designated land other than Conservation Areas. Designated land includes national parks and the Broads, Areas of Outstanding Natural Beauty, and World Heritage Sites3. The Welsh guidance states the exclusion in similar terms, extending it to sites of special scientific interest10.
- Conservation areas, with a partial exception. Conservation Areas are not excluded outright, but the rights are narrowed. For a stand-alone turbine, development is not permitted if the turbine would be nearer to any highway bounding the curtilage than the part of the house or block of flats nearest to that highway3. For a building-mounted turbine, installation is not permitted on a wall or roof slope which fronts a highway4.
The conservation area rules reward careful siting rather than forbidding the technology: a turbine placed behind the house, further from the highway than the nearest wall of the dwelling, can still qualify. The designated land exclusions are absolute, and they cover a large share of rural England, including most national park land and much of the countryside designated as Areas of Outstanding Natural Beauty. A household in a protected landscape must apply for planning permission in every case, whatever the turbine's size. The same absolute position applies to flats and caravans: permitted development of this kind does not apply to flats, caravans or other buildings11.
Article 4 directions: councils removing these rights
Even a property that satisfies every national condition may find the route closed locally. A council can take away permitted development rights using an Article 4 direction11. The Welsh guidance describes the mechanism the same way: a Local Planning Authority may have Article 4 Directions in place which remove permitted development rights in certain areas10. Permitted development rights may also have been removed by an Article 4 direction in individual cases12, and the Planning Portal notes that rights may be removed through a planning condition, an Article 4 Direction or another restriction8.
An Article 4 direction removes specified permitted development rights related to operational development or change of use14. Where a direction covers the area, an application for planning permission will be required15. These directions are most common in conservation areas12, and councils use them for precisely the kind of visible external alteration a wind turbine represents. Wandsworth, for example, has Article 4 Directions in place for specific conservation areas that control some building works11, and Wirral has only one conservation area with such a direction, Bromborough Pool15. The pattern varies sharply from one authority to another: some councils use directions widely, others barely at all.
The direction does not make the installation unlawful. It removes the automatic permission, so the work needs an application and a decision in the ordinary way. For a household, the significance is procedural and financial: what would have been free of application fees and decision timelines becomes a full planning process, with the outcome at the council's discretion.
Consulting your local planning authority before you install

The Planning Portal's advice on wind turbines is consistent across its pages: "Always check with your Local Planning Authority about planning issues before you have a system installed"1. The Local Planning Authority is usually the planning department of your local council, and for queries about a particular case, contacting it is the first thing to do16.
A pre-installation check serves three purposes. It confirms whether an Article 4 direction or a planning condition has removed the rights at your property, which is not something a householder can establish from national guidance alone13. It confirms the designations that apply, since conservation area boundaries and curtilage questions are local matters. And it can settle borderline questions, such as whether a detached building counts as within the curtilage, before money is spent. Local authorities may charge a fee for pre-application advice3, so the check is not always free, but it is cheaper than the alternative.
The guidance itself carries a disclaimer worth repeating: it is an introductory guide and not a definitive source of legal information, and additional local rules may also apply4. Northern Ireland's advice adds a practical point that applies everywhere: before proceeding, a householder should carry out a professional assessment of the local wind speed for a full year at the exact location where the turbine is planned17. The planning check and the wind assessment are separate exercises, and both belong before any commitment.
Making a planning application where the rights do not apply
Where the limits and conditions are not met, or permitted development rights have been removed in the area, an application for Householder or Full Planning Permission will be required18. The same applies where the property is a block of flats, a caravan, or a semi-detached or terraced house wanting a building-mounted turbine, since the rights simply do not extend there4.
The stakes of skipping the application are set out in government guidance: "If development is carried out without the necessary planning permission, this may lead to enforcement action"14. Enforcement is not a fine for a technicality; it can require the removal of the installation. At the same time, the guidance confirms that development does not in all instances require a planning application, which is exactly why the limits matter: the boundary between "no application needed" and "enforcement risk" is the set of conditions on this page14.
An application is assessed on its merits, so the factors that disqualify a turbine from permitted development, height above 11.1 metres, a closer boundary setback, a second turbine, a protected landscape, do not automatically defeat an application. They simply move the decision to the council. Households combining a turbine with other microgeneration should note that the one-turbine rule and the heat pump exclusion apply to the permitted development route specifically; an application can seek permission for the combination in one go. Scotland's consultation material on permitted development rights makes a parallel point for its own system: development falling within the criteria would not require planning permission but would remain subject to non-planning consents such as a building warrant19, a reminder that planning permission is one consent among several.
How the four UK nations compare
Planning is devolved, and the rules on this page are England's. The Planning Portal states it directly: "Guidance here relates to the planning regime for England, the policy in Wales may differ"1. In Wales, the same broad structure of permitted development for stand-alone turbines exists, with the 11.1 metre height limit and the height-plus-10-per-cent setback stated in Welsh guidance, but building-mounted turbines are treated differently: permitted development rights do not apply to wind turbines mounted on a dwellinghouse or building within the curtilage of the dwellinghouse in Wales10.
Scotland operates a different mechanism altogether. Since 2024, Scottish legislation provides permitted development rights for wind turbines on detached dwellinghouses and for free-standing turbines in the curtilage of a dwellinghouse, but through prior notification and prior approval: the developer must apply to the planning authority for a determination as to whether prior approval is required as to the siting, design, size and external appearance of the proposed turbine20. The Scottish circular sets the conditions, including a 15 metre blade tip height limit for free-standing turbines and the requirement that the turbine complies with MCS Planning Standards for wind turbines or equivalent standards22. The Scottish Government's review of permitted development rights has also consulted on wall or roof-mounted turbines, with conditions including compliance with MCS 020 planning standards and exclusions for conservation areas, National Parks, National Scenic Areas, Sites of Special Scientific Interest and World Heritage Sites24. Northern Ireland's position is starker: planning approval is needed for small-scale wind turbines17.

One further UK-wide point affects the financial side rather than the planning side. In 2019 changes to energy legislation, the UK was required to exclude wind and water turbines from the list of qualifying energy saving measures25, which bears on what subsidies and green finance measures a turbine can attract. For a household in England, the practical summary is this: the automatic, no-application route exists here and is comparatively generous, but it is narrow, conditional and easily closed by local designations, and the other nations each need their own check.
